Issaquah Fall City Road Phase 1 Construction Updates

Share on Facebook Share on Twitter Share on Linkedin Email this link


This Project Page features a rolling three week look-ahead keeping you up-to-date on the projects progress. For more information on the project click here.

Scroll down or click here for current updates!

Issaquah Fall City Road - Detour Route. Starting on Monday, April 20th, the roadway closure will be between 245th Lane SE and Klahanie Blvd.

What and Where:

This project will widen Issaquah Fall City Road to four lanes, between 242nd Ave SE and Klahanie Dr SE. The additional lanes along with roundabouts at 242nd, 247th, and Klahanie Drive will improve traffic flow and reduce commute times on this highly-congested roadway.


When:

Road Closure: April 13th, 2020 to January 2021 (between 247th and Klahanie Dr SE) with partial reopening of bridge (northern two lanes) end of January 2021 while utilities finish installation on south half.

Estimated End of Construction: August 2021


Work Hours:

While the school closures are in place due to COVID-19, construction hours have been extended from 7 am - 5:00 pm

Monday - Friday: 9:30 am - 3:30 pm

During road closure M-F: 7 am - 8 pm (between 247th and Klahanie Dr SE)

Optional Saturday work: 9 am - 6 pm



Why:

SE Issaquah-Fall City Road is a vital connection route to residents of the City of Sammamish and surrounding communities. This project will double the existing two-lane section, to a four-lane section, and promotes the City’s goal of complete streets by including bike lanes, sidewalks, landscaping, and a protected student crossing at Pacific Cascade Middle School. A bridge located between 247th and Klahanie Drive will raise the roadway to improve safety and meet federal driver stopping sight distance requirements. North Fork Issaquah Creek will be removed from a culvert underneath the roadway into a stream channel spanned by the bridge.

For additional information click here!



This Project Page features a rolling three week look-ahead keeping you up-to-date on the projects progress. For more information on the project click here.

Scroll down or click here for current updates!

Issaquah Fall City Road - Detour Route. Starting on Monday, April 20th, the roadway closure will be between 245th Lane SE and Klahanie Blvd.

What and Where:

This project will widen Issaquah Fall City Road to four lanes, between 242nd Ave SE and Klahanie Dr SE. The additional lanes along with roundabouts at 242nd, 247th, and Klahanie Drive will improve traffic flow and reduce commute times on this highly-congested roadway.


When:

Road Closure: April 13th, 2020 to January 2021 (between 247th and Klahanie Dr SE) with partial reopening of bridge (northern two lanes) end of January 2021 while utilities finish installation on south half.

Estimated End of Construction: August 2021


Work Hours:

While the school closures are in place due to COVID-19, construction hours have been extended from 7 am - 5:00 pm

Monday - Friday: 9:30 am - 3:30 pm

During road closure M-F: 7 am - 8 pm (between 247th and Klahanie Dr SE)

Optional Saturday work: 9 am - 6 pm



Why:

SE Issaquah-Fall City Road is a vital connection route to residents of the City of Sammamish and surrounding communities. This project will double the existing two-lane section, to a four-lane section, and promotes the City’s goal of complete streets by including bike lanes, sidewalks, landscaping, and a protected student crossing at Pacific Cascade Middle School. A bridge located between 247th and Klahanie Drive will raise the roadway to improve safety and meet federal driver stopping sight distance requirements. North Fork Issaquah Creek will be removed from a culvert underneath the roadway into a stream channel spanned by the bridge.

For additional information click here!


  • Three Week Look-Ahead 11/6 - 11/27

    Share on Facebook Share on Twitter Share on Linkedin Email this link
    13 Nov 2020
    supporting image

    Below is your three week look-ahead for 11/6 - 11/27

    Update as of 11/27:

    Issaquah-Fall City Road remains closed for construction. Local access will be maintained during the closure. The closure between 247th Place SE and Klahanie Dr. SE will now remain until the end of January 2021.

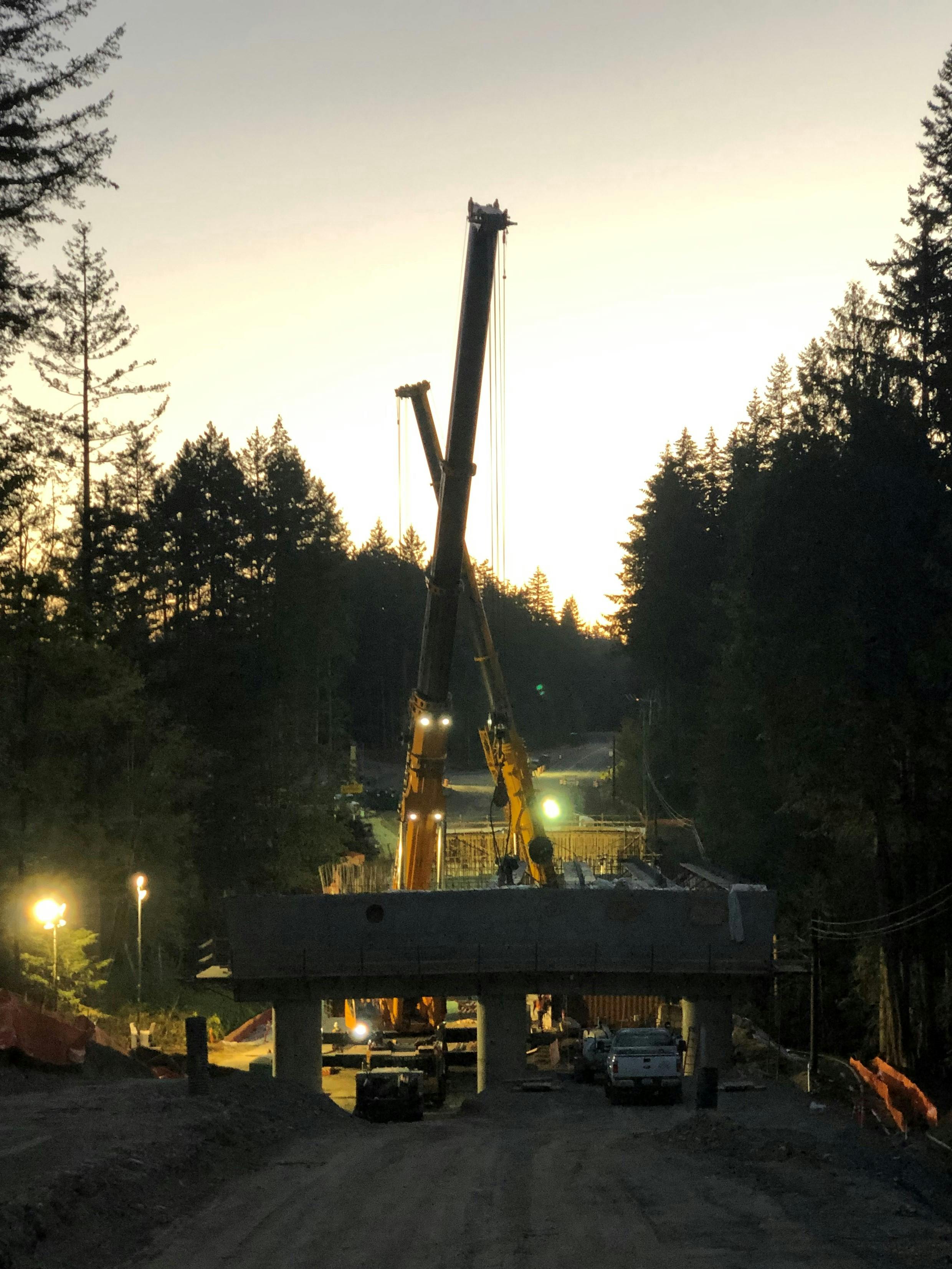

    1. Bridge crews will work a bit later than usual on December 2nd (weather permitting) to place concrete on deck two. Instead of finishing by 5 PM, the crews expect to finish between 6 PM and 8 PM.
    2. Construction of the bridge is underway with plans to open two lanes of traffic on the north half of the bridge by the end of January 2021. The south half of the bridge will remain closed while utilities are incorporated in the bridge abutment retaining walls (small wall connections).
    3. Construction of the retaining walls and bridge approaches on the east and west side of the bridge is currently being built.
    4. Between 242nd and 247th Ave. SE, traffic remains on the south side of the roadway. Work continues along the north half of the roadway in this area. The contractor is installing the concrete sidewalk along the north side and placing concrete in the median islands.
    5. Construction of the 242nd roundabout will resume earlier December, as the utilities completing the final relocations in this area.
    6. The contractor will be working on the new detention pond and storm drainage facilities at the northwest corner of the intersection of Issaquah Fall City Road and Klahanie Drive SE.
    7. With the daylight hours shortening in the fall and winter, the contractor is expected to work on the occasional Saturdays to take advantage of daylight hours, weather and keep on schedule.

    Daytime Project work hours are 7:30 a.m. to 5 p.m., Saturday Work Hours 9:00 a.m. – 6 p.m.

    Update as of 11/20:

    Issaquah-Fall City Road remains closed for construction. Local access will be maintained during the closure. The closure between 247th Place SE and Klahanie Dr. SE is still on schedule to last through the end of December 2020.

    1. Construction of the bridge is underway and on schedule to complete in December. The contractor is continuing to work on the bridge understructure by installing the concrete diaphragms between the beams (Small wall connections).
    2. Construction of the retaining walls and bridge approaches on the east and west side of the bridge is currently being built.
    3. Between 242nd and 247th Ave. SE, traffic remains on the south side of the roadway. Work continues along the north half of the roadway in this area. The contractor is installing the concrete sidewalk along the north side and placing concrete in the median islands.
    4. PSE is expected to lower their gas main at the intersection of 242nd in the early part of November, once completed the remaining utilities can be lowered and the contractor can resume construction of the roundabout.
    5. The contractor will be working on the new detention pond and storm drainage facilities at the northwest corner of the intersection of Issaquah Fall City Road and Klahanie Drive SE.
    6. With the daylight hours shortening in the fall and winter, the contractor is expected to work on the occasional Saturdays to take advantage of daylight hours, weather and keep on schedule.

    Please note that during peak delays, using the project detour route, Issaquah Beaver Lake Road to Issaquah Pine Lake Road, may result in shorter drive times. Please remember to obey all the stop signs and speed limits in the area.

    Daytime Project work hours are 7:30 a.m. to 5 p.m., Saturday Work Hours 9:00 a.m. – 6 p.m.

    Update as of 11/13:

    Issaquah-Fall City Road remains closed for construction. Local access will be maintained during the closure. The closure between 247th Place SE and Klahanie Dr. SE is still on schedule to last through the end of December 2020.

    1. Construction of the bridge is underway and on schedule to complete in December. The contractor is continuing to work on the bridge understructure by installing the concrete diaphragms between the beams (Small wall connections).
    2. Construction of the retaining walls and bridge approaches on the east and west side of the bridge is currently being built.
    3. Between 242nd and 247th Ave. SE, traffic remains on the south side of the roadway.Work continues along the north half of the roadway in this area. The contractor is installing the concrete sidewalk along the north side and placing concrete in the median islands.
    4. PSE is expected to lower their gas main at the intersection of 242nd in the early part of November, once completed the remaining utilities can be lowered and the contractor can resume construction of the roundabout.
    5. The contractor will be working on the new detention pond and storm drainage facilities at the northwest corner of the intersection of Issaquah Fall City Road and Klahanie Drive SE.
    6. With the daylight hours shortening in the fall and winter, the contractor is expected to work on the occasional Saturdays to take advantage of daylight hours, weather and keep on schedule.

    Please note that during peak delays, using the project detour route, Issaquah Beaver Lake Road to Issaquah Pine Lake Road, may result in shorter drive times. Please remember to obey all the stop signs and speed limits in the area.

    Daytime Project work hours are 7:30 a.m. to 5 p.m., Saturday Work Hours 9:00 a.m. – 6 p.m.

    Update as of 11/6:

    Issaquah-Fall City Road remains closed for construction. Local access will be maintained during the closure. The closure between 247th Place SE and Klahanie Dr. SE is still on schedule to last through the end of December 2020.

    1. Construction of the bridge is underway and on schedule to complete in December. The contractor is continuing to work on the bridge understructure by installing the concrete diaphragms between the beams (Small wall connections).
    2. Construction of the retaining walls and bridge approaches on the east and west side of the bridge is currently being built.
    3. Between 242nd and 247th Ave. SE, traffic remains on the south side of the roadway.Work continues along the north half of the roadway in this area. The contractor is installing the concrete sidewalk along the north side and placing concrete in the median islands.
    4. PSE is expected to lower their gas main at the intersection of 242nd in the early part of November, once completed the remaining utilities can be lowered and the contractor can resume construction of the roundabout.
    5. The contractor will be working on the new detention pond and storm drainage facilities at the northwest corner of the intersection of Issaquah Fall City Road and Klahanie Drive SE.
    6. With the daylight hours shortening in the fall and winter, the contractor is expected to work on the occasional Saturdays to take advantage of daylight hours, weather and keep on schedule.

    Please note that during peak delays, using the project detour route, Issaquah Beaver Lake Road to Issaquah Pine Lake Road, may result in shorter drive times. Please remember to obey all the stop signs and speed limits in the area.

  • Three Week Look-Ahead 10/16 - 11/6

    Share on Facebook Share on Twitter Share on Linkedin Email this link
    23 Oct 2020
    supporting image

    Below is your three week look-ahead for 10/16 - 11/6

    Update as of 11/6:

    Issaquah-Fall City Road remains closed for construction. Local access will be maintained during the closure. The closure between 247th Place SE and Klahanie Dr. SE is still on schedule to last through the end of December 2020.

    1. Construction of the bridge is underway and on schedule to complete in December. The contractor is continuing to work on the bridge understructure by installing the concrete diaphragms between the beams (Small wall connections).
    2. Construction of the retaining walls and bridge approaches on the east and west side of the bridge is currently being built.
    3. Between 242nd and 247th Ave. SE, traffic remains on the south side of the roadway.Work continues along the north half of the roadway in this area. The contractor is installing the concrete sidewalk along the north side and placing concrete in the median islands.
    4. PSE is expected to lower their gas main at the intersection of 242nd in the early part of November, once completed the remaining utilities can be lowered and the contractor can resume construction of the roundabout.
    5. The contractor will be working on the new detention pond and storm drainage facilities at the northwest corner of the intersection of Issaquah Fall City Road and Klahanie Drive SE.
    6. With the daylight hours shortening in the fall and winter, the contractor is expected to work on the occasional Saturdays to take advantage of daylight hours, weather and keep on schedule.

    Please note that during peak delays, using the project detour route, Issaquah Beaver Lake Road to Issaquah Pine Lake Road, may result in shorter drive times. Please remember to obey all the stop signs and speed limits in the area.

    Update as of 10/30:

    Issaquah-Fall City Road remains closed for construction. Local access will be maintained during the closure. The closure between 247th Place SE and Klahanie Dr. SE is still on schedule to last through the end of December 2020.

    1. Construction of the bridge is underway and on schedule to complete in December. The contractor is continuing to work on the bridge understructure by installing the concrete diaphragms between the beams (Small wall connections).
    2. Construction of the retaining walls and bridge approaches on the east and west side of the bridge is currently being built.
    3. Between 242nd and 247th Ave. SE, traffic remains on the south side of the roadway.Work continues along the north half of the roadway in this area. The contractor is installing the concrete sidewalk along the north side and placing concrete in the median islands.
    4. PSE is expected to lower their gas main at the intersection of 242nd in the early part of November, once completed the remaining utilities can be lowered and the contractor can resume construction of the roundabout.
    5. The contractor will be working on the new detention pond and storm drainage facilities at the northwest corner of the intersection of Issaquah Fall City Road and Klahanie Drive SE.
    6. With the daylight hours shortening in the fall and winter, the contractor is expected to work on the occasional Saturdays to take advantage of daylight hours, weather and keep on schedule.

    Please note that during peak delays, using the project detour route, Issaquah Beaver Lake Road to Issaquah Pine Lake Road, may result in shorter drive times. Please remember to obey all the stop signs and speed limits in the area.

    Daytime Project work hours are 7:30 a.m. to 5 p.m., Saturday Work Hours 9:00 a.m. – 6 p.m.

    Update as of 10/23:

    Issaquah-Fall City Road remains closed for construction. Local access will be maintained during the closure. The closure between 247th Place SE and Klahanie Dr. SE is still on schedule to last through the end of December 2020.

    1. Construction of the bridge is underway and on schedule to complete in December. The contractor is continuing to work on the bridge understructure by installing the concrete diaphragms between the beams (Small wall connections).
    2. Construction of the retaining walls and bridge approaches on the east and west side of the bridge is currently being built.
    3. Between 242nd and 247th Ave. SE, traffic remains on the south side of the roadway.Work continues along the north half of the roadway in this area. The contractor is installing the concrete sidewalk along the north side and placing concrete in the median islands.
    4. PSE is expected to lower their gas main at the intersection of 242nd in the early part of November, once completed the remaining utilities can be lowered and the contractor can resume construction of the roundabout.
    5. The contractor will be working on the new detention pond and storm drainage facilities at the northwest corner of the intersection of Issaquah Fall City Road and Klahanie Drive SE.
    6. With the daylight hours shortening in the fall and winter, the contractor is expected to work on the occasional Saturdays to take advantage of daylight hours, weather and keep on schedule.

    Please note that during peak delays, using the project detour route, Issaquah Beaver Lake Road to Issaquah Pine Lake Road, may result in shorter drive times. Please remember to obey all the stop signs and speed limits in the area.

    Daytime Project work hours are 7:30 a.m. to 5 p.m., Saturday Work Hours 9:00 a.m. – 6 p.m.

    Update as of 10/16:

    Issaquah-Fall City Road remains closed for construction. Local access will be maintained during the closure. The closure between 247th Place SE and Klahanie Dr. SE is still on schedule to last through the end of December 2020.

    1. Construction of the bridge is underway and on schedule to complete in December. The contractor is continuing to work on the bridge understructure by installing the concrete diaphragms between the beams (Small wall connections).
    2. Construction of the retaining walls and bridge approaches on the east and west side of the bridge is currently being built.
    3. Between 242nd and 247th Ave. SE, traffic remains on the south side of the roadway. Work continues along the north half of the roadway in this area. The contractor is installing the concrete sidewalk along the north side and placing concrete in the median islands.
    4. The contractor is also installing a new water main between 242nd and 247th in conjunction with this project.
    5. PSE is expected to lower their gas main at the intersection of 242nd in the early part of November, once completed the remaining utilities can be lowered and the contractor can resume construction of the roundabout.
    6. With the daylight hours shortening in the fall and winter, the contractor is expected to work on the occasional Saturdays to take advantage of daylight hours, weather and keep on schedule.

    Please note that during peak delays, using the project detour route, Issaquah Beaver Lake Road to Issaquah Pine Lake Road, may result in shorter drive times. Please remember to obey all the stop signs and speed limits in the area.

    Daytime Project work hours are 7:30 a.m. to 5 p.m., Saturday Work Hours 9:00 a.m. – 6 p.m.


  • Three Week Look-Ahead 9/25 - 10/16

    Share on Facebook Share on Twitter Share on Linkedin Email this link
    02 Oct 2020
    supporting image

    Below is your three week look-ahead for 9/25 - 10/16

    Update as of 10/16:

    Issaquah-Fall City Road remains closed for construction. Local access will be maintained during the closure. The closure between 247th Place SE and Klahanie Dr. SE is still on schedule to last through the end of December 2020.

    1. Construction of the bridge is underway and on schedule to complete in December. The contractor is continuing to work on the bridge understructure by installing the concrete diaphragms between the beams (Small wall connections).
    2. Construction of the retaining walls and bridge approaches on the east and west side of the bridge is currently being built.
    3. Between 242nd and 247th Ave. SE, traffic remains on the south side of the roadway. Work continues along the north half of the roadway in this area. The contractor is installing the concrete sidewalk along the north side and placing concrete in the median islands.
    4. The contractor is also installing a new water main between 242nd and 247th in conjunction with this project.
    5. PSE is expected to lower their gas main at the intersection of 242nd in the early part of November, once completed the remaining utilities can be lowered and the contractor can resume construction of the roundabout.
    6. With the daylight hours shortening in the fall and winter, the contractor is expected to work on the occasional Saturdays to take advantage of daylight hours, weather and keep on schedule.

    Please note that during peak delays, using the project detour route, Issaquah Beaver Lake Road to Issaquah Pine Lake Road, may result in shorter drive times. Please remember to obey all the stop signs and speed limits in the area.

    Daytime Project work hours are 7:30 a.m. to 5 p.m., Saturday Work Hours 9:00 a.m. – 6 p.m.

    Update as of 10/9:

    Issaquah-Fall City Road remains closed for construction. Local access will be maintained during the closure. The closure between 247th Place SE and Klahanie Dr. SE is still on schedule to last through the end of December 2020.

    1. Construction of the bridge is underway and on schedule to complete in December. The contractor is continuing to work on the bridge understructure by installing the concrete diaphragms between the beams (Small wall connections).
    2. Construction of the retaining walls and bridge approaches on the east and west side of the bridge is currently being built.
    3. Between 242nd and 247th Ave. SE, traffic remains on the south side of the roadway.Work continues along the north half of the roadway in this area. The contractor is installing the concrete curb and sidewalk along the north side and placing concrete in the median islands. The contractor will also continue to work at the intersection of 247th Ave. SE near the middle school and 242nd Ave SE. The work is weather dependent; sunny days next week should allow the asphalt pavement to be done. There will be more construction traffic through the site as a result.

    Please note that during peak delays, using the project detour route, Issaquah Beaver Lake Road to Issaquah Pine Lake Road, may result in shorter drive times. Please remember to obey all the stop signs and speed limits in the area.

    Daytime Project work hours are 7:30 a.m. to 5 p.m.

    Update as of 10/2:

    Issaquah-Fall City Road remains closed for construction. Local access will be maintained during the closure. The closure between 247th Place SE and Klahanie Dr. SE is still on schedule to last through the end of December 2020.

    1. Construction of the bridge is underway and on schedule to complete in December. The contractor is continuing to work on the bridge understructure by installing the concrete diaphragms between the beams (Small wall connections).
    2. Construction of the retaining walls and bridge approaches on the east and west side of the bridge is currently being built.
    3. Between 242nd and 247th Ave. SE, traffic remains on the south side of the roadway.Work continues along the north half of the roadway in this area. The contractor is installing the concrete curb and sidewalk along the north side and placing concrete in the median islands. The contractor will also continue to work at the intersection of 247th Ave. SE near the middle school and 242nd Ave SE. The work is weather dependent; sunny days next week should allow the asphalt pavement to be done. There will be more construction traffic through the site as a result.

    Please note that during peak delays, using the project detour route, Issaquah Beaver Lake Road to Issaquah Pine Lake Road, may result in shorter drive times. Please remember to obey all the stop signs and speed limits in the area.

    Daytime Project work hours are 7:30 a.m. to 5 p.m.

    Update as of 9/25

    Issaquah-Fall City Road remains closed for construction. Local access will be maintained during the closure. The closure between 247th Place SE and Klahanie Dr. SE is still on schedule to last through the end of December 2020.

    1. Construction of the bridge is underway and on schedule to complete in December. The contractor is continuing to work on the bridge understructure by installing the concrete diaphragms between the beams (Small wall connections).
    2. Construction of the retaining walls and bridge approaches on the east and west side of the bridge is currently being built.
    3. Between 242nd and 247th Ave. SE, traffic remains on the south side of the roadway. Work continues along the north half of the roadway in this area. The contractor is installing the concrete curb and sidewalk along the north side and median islands. The contractor will also continue to work at the intersection of 247th Ave. SE near the middle school and 242nd Ave SE. During the week of September 28, the contractor will be finishing the current phase of placing asphalt along the north half of the site and at the intersection of 242nd, 247th, and Klahanie Drive and Issaquah Fall City Road, as well as the intersection of SE 46th. The work is weather dependent; sunny days next week should allow the asphalt pavement to be done. There will be more construction traffic through the site as a result.

    Please note that during peak delays, using the project detour route, Issaquah Beaver Lake Road to Issaquah Pine Lake Road, may result in shorter drive times. Please remember to obey all the stop signs and speed limits in the area.

    Daytime Project work hours are 7 a.m. to 5 p.m.

  • Three Week Look-Ahead 9/4 - 9/25

    Share on Facebook Share on Twitter Share on Linkedin Email this link
    14 Sep 2020
    supporting image

    Below is your three week look-ahead from 9/4 - 9/25

    Update as of 9/25:

    Issaquah-Fall City Road remains closed for construction. Local access will be maintained during the closure. The closure between 247th Place SE and Klahanie Dr. SE is still on schedule to last through the end of December 2020.

    1. Construction of the bridge is underway and on schedule to complete in December. The contractor is continuing to work on the bridge understructure by installing the concrete diaphragms between the beams (Small wall connections).
    2. Construction of the retaining walls and bridge approaches on the east and west side of the bridge is currently being built.
    3. Between 242nd and 247th Ave. SE, traffic remains on the south side of the roadway. Work continues along the north half of the roadway in this area. The contractor is installing the concrete curb and sidewalk along the north side and median islands. The contractor will also continue to work at the intersection of 247th Ave. SE near the middle school and 242nd Ave SE. During the week of September 28, the contractor will be finishing the current phase of placing asphalt along the north half of the site and at the intersection of 242nd, 247th, and Klahanie Drive and Issaquah Fall City Road, as well as the intersection of SE 46th. The work is weather dependent; sunny days next week should allow the asphalt pavement to be done. There will be more construction traffic through the site as a result.

    Please note that during peak delays, using the project detour route, Issaquah Beaver Lake Road to Issaquah Pine Lake Road, may result in shorter drive times. Please remember to obey all the stop signs and speed limits in the area.

    Daytime Project work hours are 7 a.m. to 5 p.m.

    Update as of 9/18

    Issaquah-Fall City Road remains closed for construction. Local access will be maintained during the closure. The closure between 247th Place SE and Klahanie Dr. SE is still on schedule to last through the end of December 2020.

    1. Construction of the bridge is underway and on schedule to complete in December. The contractor is continuing to work on the bridge understructure by installing the concrete diaphragms between the beams (Small wall connections).
    2. Construction of the retaining walls and bridge approaches on the east and west side of the bridge is currently being built.
    3. Between 242nd and 247th Ave. SE, traffic remains on the south side of the roadway.Work continues along the north half of the roadway in this area. The contractor is installing the concrete curb and sidewalk along the north side and median islands. The contractor will also continue to work at the intersection of 247th Ave. SE near the middle school. During the week of September 21, the contractor will be placing asphalt along the north half of the site and at the intersection of 242nd, 247th and Klahanie Drive and Issaquah Fall City Road, as well as the intersection of 247th and SE 46th. There will be more construction traffic through the site as a result.

    Please note that during peak delays, using the project detour route, Issaquah Beaver Lake Road to Issaquah Pine Lake Road, may result in shorter drive times. Please remember to obey all the stop signs and speed limits in the area.

    Update as of 9/11

    Issaquah-Fall City Road remains closed for construction. Local access will be maintained during the closure. The closure between 247th Place SE and Klahanie Dr. SE is still on schedule to last through the end of December 2020.

    1. Construction of the bridge is underway and on schedule to complete in December. The contractor is continuing to work on the bridge understructure by installing the concrete diaphragms between the beams. (Small wall connections)
    2. Construction of the retaining walls and bridge approach from 247th on the west side of the bridge is currently being built.
    3. Between 242nd and 247th Ave. SE, traffic remains on the south side of the roadway.Work continues along the north half of the roadway in this area. The contractor is installing the concrete curb and sidewalk along the north side and median islands. The contractor will also continue to work at the intersection of 247th Ave. SE near the middle school. Asphalt for the roadway and roundabout at 247th is scheduled to occur at the end of September.

    Please note that during peak delays, using the project detour route, Issaquah Beaver Lake Road to Issaquah Pine Lake Road, may result in shorter drive times. Please remember to obey all the stop signs and speed limits in the area.

    Update as of 9/4:

    Issaquah-Fall City Road remains closed for construction. Local access will be maintained during the closure. The closure between 247th Place SE and Klahanie Dr. SE is still on schedule to last through the end of December 2020.

    1. The roundabout at SE Issaquah-Beaver Lake Rd./256th Ave. SE/SE 32nd St/E Beaver Lake Dr. SE is operational. There will be a contractor completing work on the sidewalks and wheelchair ramps during the week.
    2. Construction of the bridge is underway and on schedule to complete in December.
    3. Between 242nd and 247th Ave. SE, traffic remains on the south side of the roadway.Work continues along the north half of the roadway in this area. The contractor and the utility companies will be working on relocations in these limits. Grading work, concrete curb, and sidewalk placement have been extended due to work related to the underground utilities. The contractor will continue to work at the intersection of 247th Ave. SE near the middle school. Placement of asphalt is occured at the end of August.

    Please note that during peak delays, using the project detour route, Issaquah Beaver Lake Road to Issaquah Pine Lake Road, may result in shorter drive times. Please remember to obey all the stop signs and speed limits in the area.

    Daytime Project work hours are 7 a.m. to 5 p.m.

  • Three Week Look-Ahead 8/14 - 9/4

    Share on Facebook Share on Twitter Share on Linkedin Email this link
    21 Aug 2020
    supporting image

    Below is your three week look-ahead for 8/14 - 9/4

    Update as of 9/4:

    Issaquah-Fall City Road remains closed for construction. Local access will be maintained during the closure. The closure between 247th Place SE and Klahanie Dr. SE is still on schedule to last through the end of December 2020.

    1. The roundabout at SE Issaquah-Beaver Lake Rd./256th Ave. SE/SE 32nd St/E Beaver Lake Dr. SE is operational. There will be a contractor completing work on the sidewalks and wheelchair ramps during the week.
    2. Construction of the bridge is underway and on schedule to complete in December.
    3. Between 242nd and 247th Ave. SE, traffic remains on the south side of the roadway.Work continues along the north half of the roadway in this area. The contractor and the utility companies will be working on relocations in these limits. Grading work, concrete curb, and sidewalk placement have been extended due to work related to the underground utilities. The contractor will continue to work at the intersection of 247th Ave. SE near the middle school. Placement of asphalt is occured at the end of August.

    Please note that during peak delays, using the project detour route, Issaquah Beaver Lake Road to Issaquah Pine Lake Road, may result in shorter drive times. Please remember to obey all the stop signs and speed limits in the area.

    Daytime Project work hours are 7 a.m. to 5 p.m.

    Update as of 8/28:

    Issaquah-Fall City Road remains closed for construction. Local access will be maintained during the closure. The closure between 247th Place SE and Klahanie Dr. SE is still on schedule to last through the end of December 2020.

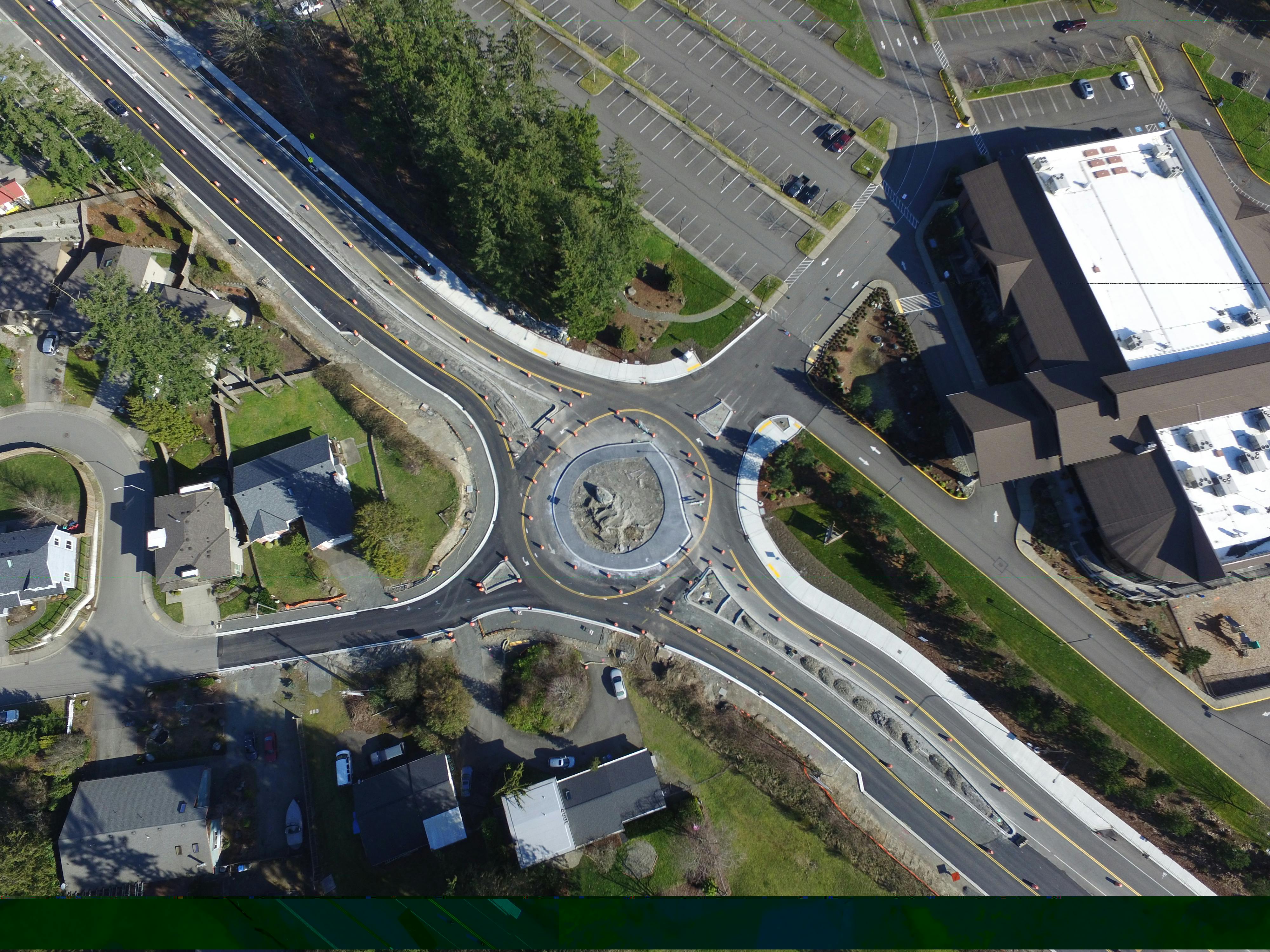

    1. The roundabout at SE Issaquah-Beaver Lake Rd./256th Ave. SE/SE 32nd St/E Beaver Lake Dr. SE is operational. There will be a contractor completing work on the sidewalks and wheelchair ramps during the week.
    2. Construction of the bridge is underway and on schedule to complete in December. The contractor will continue to place girders on the nights of Monday August 31st, and Tuesday September 1st.
    3. Between 242nd and 247th Ave. SE, traffic remains on the south side of the roadway.Work continues along the north half of the roadway in this area. The contractor and the utility companies will be working on relocations in these limits. Grading work, concrete curb, and sidewalk placement have extended into August due to work related to the underground utilities. The contractor will continue to work next week at the intersection of 247th Ave. SE near the middle school. Placement of asphalt is currently on schedule to occur at the end of August.

    Please note that during peak delays, using the project detour route, Issaquah Beaver Lake Road to Issaquah Pine Lake Road, may result in shorter drive times. Please remember to obey all the stop signs and speed limits in the area.

    Daytime Project work hours are 7 a.m. to 5 p.m.

    NOTICE OF NIGHTTIME WORK: Hours are 7 p.m. to 7 a.m. during the nights of August 31 and September 1. Work includes bridge girder delivery and installation. Equipment will consist of two large cranes and semi-truck transports.

    Update as of 8/21:

    Issaquah-Fall City Road remains closed for construction. Local access will be maintained during the closure. The closure between 247th Place SE and Klahanie Dr. SE is still on schedule to last through the end of December 2020.

    1. The roundabout at SE Issaquah-Beaver Lake Rd./256th Ave. SE/SE 32nd St/E Beaver Lake Dr. SE is operational. There will be a contractor completing work on the sidewalks and wheelchair ramps during the week.
    2. Construction of the bridge is underway and on schedule to complete in December. The contractor will be placing girders during the nights of August 24th through August 27th, and the nights of Monday August 31st, and Tuesday September 1st.
    3. Between 242nd and 247th Ave. SE, traffic remains on the south side of the roadway.Work continues along the north half of the roadway in this area. The contractor and the utility companies will be working on relocations in these limits. Grading work, concrete curb, and sidewalk placement have extended into August due to work related to the underground utilities. The contractor will continue to work next week at the intersection of 247th Ave. SE near the middle school. Placement of asphalt is currently on schedule to occur at the end of August.

    Please note that during peak delays, using the project detour route, Issaquah Beaver Lake Road to Issaquah Pine Lake Road, may result in shorter drive times. Please remember to obey all the stop signs and speed limits in the area.

    Daytime Project work hours are 7 a.m. to 5 p.m.

    NOTICE OF NIGHTTIME WORK: Hours are 7 p.m. to 7 a.m. during the nights of August 24, 25, 26, 27, 31, and September 1. Work includes bridge girder delivery and installation. Equipment will consist of two large cranes and semi-truck transports.


    Update as of 8/14:

    Issaquah-Fall City Road remains closed for construction. Local access will be maintained during the closure. The closure between 247th Place SE and Klahanie Dr. SE is still on schedule to last through the end of December 2020.

    1. The roundabout at SE Issaquah-Beaver Lake Rd./256th Ave. SE/SE 32nd St/E Beaver Lake Dr. SE is operational. There will be a contractor performing work on the sidewalks and wheelchair ramps during the week.
    2. Construction of the bridge is underway and on schedule to complete in December. The contractor is working to complete the top beams to the substructure in preparation of the girder installation. The girders for the bridge are being delivered and installed during the week of August 24th. Girder installation will be occurring during the night time hours of August 24-August 28.
    3. Between 242nd and 247th Ave. SE, traffic remains on the south side of the roadway.Work continues along the north half of the roadway in this area. The contractor and the utility companies will be working on relocations in these limits. Grading work, concrete curb and sidewalk placement have extended into August due to work related to the underground utilities. The contractor will continue to work next week in the intersection of 247th Ave. SE near the middle school. Placement of asphalt is currently on schedule to occur at the end of August.

    Please note that during peak delays, using the project detour route, Issaquah Beaver Lake Road to Issaquah Pine Lake Road, may result in shorter drive times. Please remember to obey all the stop signs and speed limits in the area.

    Project work hours are 7 a.m. to 5 p.m.

    Bridge crews between Klahanie Dr. SE and 247th continue to begin at 7:00 a.m., following the required health check-up. Road crews between 242nd and 247th continue to start at 7:30 a.m., following the required health check-up.

  • Night Time Bridge Construction 8/24-27, 8/31 and 9/1

    Share on Facebook Share on Twitter Share on Linkedin Email this link
    18 Aug 2020
    supporting image

    The contractor constructing the bridge along Issaquah Fall City Road will be installing bridge girders during the night time hours of 7:00 PM to 7:00 AM on August 24th-27th, 31st, and 9/1

    When: Girders are scheduled to be delivered beginning on the night of Monday August 24th. The work will run though Thursday August 27th, stop over the weekend and finish during the nights of Monday August 31st and Tuesday September 1st.

    Hours: 7:00 PM - 7:00 AM

    Girder Delivery Route: Johansen Construction Company, Inc. and its subcontractors will be delivering bridge girders through SE Issaquah-Fall City Road with the limits being WA-202 (Redmond-Fall City Road) to Klahanie Drive SE.

    Night Time Work Noise: The contractor has been restricted to limit the noise down to a lower level. Equipment will be directed through radio and hand signals. Back up beeps on the vehicles will not be in operation during night hours.

    Site Access: The portion of the roadway where the bridge construction is will remain closed to the public. Access for the girders will be through the Klahanie Drive intersection along Issaquah Fall City Road. Please work with the flaggers for travel through the site during delivery and observe all construction signs. We apologize for any inconvenience while we make these deliveries.

    Thank you very much in advance for your patience and cooperation with construction of this large capital project for the City.

    Questions or Comments?

    City Contact: Andrew Zagars P.E.

    azagars@sammamish.us

    (425) 295-0561



  • Three Week Look-Ahead 7/24 - 8/14

    Share on Facebook Share on Twitter Share on Linkedin Email this link
    27 Jul 2020
    supporting image

    Below is your three week look-ahead for 7/24 - 8/14

    Update as of 8/14:

    Issaquah-Fall City Road remains closed for construction. Local access will be maintained during the closure. The closure between 247th Place SE and Klahanie Dr. SE is still on schedule to last through the end of December 2020.

    1. The roundabout at SE Issaquah-Beaver Lake Rd./256th Ave. SE/SE 32nd St/E Beaver Lake Dr. SE is operational. There will be a contractor performing work on the sidewalks and wheelchair ramps during the week.
    2. Construction of the bridge is underway and on schedule to complete in December. The contractor is working to complete the top beams to the substructure in preparation of the girder installation. The girders for the bridge are being delivered and installed during the week of August 24th. Girder installation will be occurring during the night time hours of August 24-August 28.
    3. Between 242nd and 247th Ave. SE, traffic remains on the south side of the roadway.Work continues along the north half of the roadway in this area. The contractor and the utility companies will be working on relocations in these limits. Grading work, concrete curb and sidewalk placement have extended into August due to work related to the underground utilities. The contractor will continue to work next week in the intersection of 247th Ave. SE near the middle school. Placement of asphalt is currently on schedule to occur at the end of August.

    Please note that during peak delays, using the project detour route, Issaquah Beaver Lake Road to Issaquah Pine Lake Road, may result in shorter drive times. Please remember to obey all the stop signs and speed limits in the area.

    Project work hours are 7 a.m. to 5 p.m.

    Bridge crews between Klahanie Dr. SE and 247th continue to begin at 7:00 a.m., following the required health check-up. Road crews between 242nd and 247th continue to start at 7:30 a.m., following the required health check-up.

    Update as of 8/7:

    Issaquah-Fall City Road remains closed for construction. Local access will be maintained during the closure. The closure between 247th Place SE and Klahanie Dr. SE is still on schedule to last through the end of December 2020.

    1. The roundabout at SE Issaquah-Beaver Lake Rd./256th Ave. SE/SE 32nd St/E Beaver Lake Dr. SE is operational. Only final touch-ups are remaining, which are being scheduled once all the parts arrive. The sidewalk, final curb adjustment, and curb ramps around the intersection are currently on schedule to start the second week of August.
    2. Construction of the bridge is underway and on schedule to complete in December. The contractor has completed the columns for each of the bridge sections and are working on the top cross beams. The girders for the bridge are expected to be delivered and installed at the end of August.
    3. Between 242nd and 247th Ave. SE, traffic remains on the south side of the roadway.Work continues along the north half of the roadway in this area. The contractor and the utility companies will be working on relocations in these limits. Grading work, concrete curb and sidewalk placement have extended into August due to work related to the underground utilities. The contractor will continue to work next week in the intersection of 247th Ave. SE near the middle school. Placement of asphalt is currently on schedule to occur at the end of August.

    Please note that during peak delays, using the project detour route, Issaquah Beaver Lake Road to Issaquah Pine Lake Road, may result in shorter drive times. Please remember to obey all the stop signs and speed limits in the area.

    Project work hours are 7 a.m. to 5 p.m.

    Bridge crews between Klahanie Dr. SE and 247th continue to begin at 7:00 a.m., following the required health check-up. Road crews between 242nd and 247th continue to start at 7:30 a.m., following the required health check-up.

    Update as of 7/31

    Issaquah-Fall City Road remains closed for construction. Local access will be maintained during the closure. The closure between 247th Place SE and Klahanie Dr. SE is still on schedule to last through the end of December 2020.

    • The roundabout at SE Issaquah-Beaver Lake Rd./256th Ave. SE/SE 32nd St/E Beaver Lake Dr. SE is operational. Only final touch-ups are remaining, which are being scheduled once all the parts arrive. The sidewalk, final curb adjustment, and curb ramps around the intersection are currently on schedule to start the second week of August.
    • Construction of the bridge is underway and on schedule to complete in December. The contractor has completed the columns for each of the bridge sections and are working on the top cross beams. The girders for the bridge are expected to be delivered and installed at the end of August.
    • Between 242nd and 247th Ave. SE, traffic remains on the south side of the roadway.Work continues along the north half of the roadway in this area. The contractor and the utility companies will be working on relocations in these limits. Grading work and concrete curb and sidewalk placement have extended into August due to work related to the underground utilities. The contractor will continue to work next week in the intersection of 247th Ave. SE near the middle school. Placement of asphalt is currently on schedule to occur at the end of July.

    Please note that during peak delays, using the project detour route, Issaquah Beaver Lake Road to Issaquah Pine Lake Road, may result in shorter drive times. Please remember to obey all the stop signs and speed limits in the area.

    Project work hours are 7 a.m. to 5 p.m.

    Bridge crews between Klahanie Dr. SE and 247th continue to begin at 7:00 a.m., following the required health check-up. Road crews between 242nd and 247th continue to start at 7:30 a.m., following the required health check-up.

    Update as of 7/24:

    Issaquah-Fall City Road remains closed for construction. Local access will be maintained during the closure. The closure between 247th Place SE and Klahanie Dr. SE is expected to last through December 2020.

    • The roundabout at SE Issaquah-Beaver Lake Rd./256th Ave. SE/SE 32nd St/E Beaver Lake Dr. SE is operational. Only final touch-ups are remaining, which are being scheduled once all the parts arrive. The sidewalk, final curb adjustment, and curb ramps around the intersection will be made at the end of July/early August. The new street lights are expected to be installed and operational by the end of July.
    • Construction of the bridge in underway. The contractor has completed the columns for each of the bridge sections. The contractor is currently working on the pile caps and the access road for the girder delivery. The girders are expected to begin delivery in 2 weeks.
    • Between 242nd and 247th Ave. SE, traffic remains on the south side of the roadway.Work continues along the north half of the roadway in this area. The contractor and the utility companies will be working on relocations in these limits. Grading work and concrete curb and sidewalk placement will continue through July. The contractor will continue to work in the intersection of 247th Ave. SE near the middle school. Placement of asphalt is expected to occur at the end of July.

    Please note that during peak delays, using the project detour route, Issaquah Beaver Lake Road to Issaquah Pine Lake Road, may result in shorter drive times. Please remember to obey all the stop signs and speed limits in the area.

    Project work hours are 7 a.m. to 5 p.m.

    Bridge crews between Klahanie Dr. SE and 247th continue to begin at 7:00 a.m., following the required health check-up. Road crews between 242nd and 247th continue to start at 7:30 a.m., following the required health check-up.

  • Three Week Look-Ahead 7/3 - 7/24

    Share on Facebook Share on Twitter Share on Linkedin Email this link
    10 Jul 2020
    supporting image

    Below is your three week look-ahead for 7/3 - 7/24

    Update as of 7/24:

    Issaquah-Fall City Road remains closed for construction. Local access will be maintained during the closure. The closure between 247th Place SE and Klahanie Dr. SE is expected to last through December 2020.

    • The roundabout at SE Issaquah-Beaver Lake Rd./256th Ave. SE/SE 32nd St/E Beaver Lake Dr. SE is operational. Only final touch-ups are remaining, which are being scheduled once all the parts arrive. The sidewalk, final curb adjustment, and curb ramps around the intersection will be made at the end of July/early August. The new street lights are expected to be installed and operational by the end of July.
    • Construction of the bridge in underway. The contractor has completed the columns for each of the bridge sections. The contractor is currently working on the pile caps and the access road for the girder delivery. The girders are expected to begin delivery in 2 weeks.
    • Between 242nd and 247th Ave. SE, traffic remains on the south side of the roadway.Work continues along the north half of the roadway in this area. The contractor and the utility companies will be working on relocations in these limits. Grading work and concrete curb and sidewalk placement will continue through July. The contractor will continue to work in the intersection of 247th Ave. SE near the middle school. Placement of asphalt is expected to occur at the end of July.

    Please note that during peak delays, using the project detour route, Issaquah Beaver Lake Road to Issaquah Pine Lake Road, may result in shorter drive times. Please remember to obey all the stop signs and speed limits in the area.

    Project work hours are 7 a.m. to 5 p.m.

    Bridge crews between Klahanie Dr. SE and 247th continue to begin at 7:00 a.m., following the required health check-up. Road crews between 242nd and 247th continue to start at 7:30 a.m., following the required health check-up.

    Update as of 7/17:

    Issaquah-Fall City Road remains closed for construction. Local access will be maintained during the closure. The closure between 247th Place SE and Klahanie Dr. SE is expected to last through December 2020.

    • The roundabout at SE Issaquah-Beaver Lake Rd./256th Ave. SE/SE 32nd St/E Beaver Lake Dr. SE is operational. Only final touch-ups are remaining, which are being scheduled once all the parts arrive. The sidewalk, final curb adjustment, and curb ramps around the intersection will be made at the end of July/early August. The new street lights are expected to be installed and operational by the end of July.
    • Construction of the bridge in underway. The contractor has completed the columns for each of the bridge sections. The contractor is currently working on the pile caps and the access road for the girder delivery. The girders are expected to begin delivery in 2 weeks.
    • Between 242nd and 247th Ave. SE, traffic remains on the south side of the roadway.Work continues along the north half of the roadway in this area. The contractor and the utility companies will be working on relocations in these limits. Grading work and concrete curb and sidewalk placement will continue through July. The contractor will continue to work in the intersection of 247th Ave. SE near the middle school. Placement of asphalt is expected to occur at the end of July.

    Please note that during peak delays, using the project detour route, Issaquah Beaver Lake Road to Issaquah Pine Lake Road, may result in shorter drive times. Please remember to obey all the stop signs and speed limits in the area.

    Project work hours are 7 a.m. to 5 p.m.

    Bridge crews between Klahanie Dr. SE and 247th continue to begin at 7:00 a.m., following the required health check-up. Road crews between 242nd and 247th continue to start at 7:30 a.m., following the required health check-up.

    Update as of 7/10:

    Issaquah-Fall City Road remains closed for construction. Local access will be maintained during the closure. The closure between 247th Place SE and Klahanie Dr. SE is expected to last through December 2020.

    • The roundabout at SE Issaquah-Beaver Lake Rd./256th Ave. SE/SE 32nd St/E Beaver Lake Dr. SE is operational. Only final touch-ups are remaining, which are being scheduled once all the parts arrive. The sidewalk around the intersection will be replaced this month. The work will include relocating existing ramps and placement of new concrete and curb in around the roundabout to better improve access for pedestrians to the crossing locations.
    • Construction of the bridge in underway. The contractor has completed the columns for each of the bridge sections. Next, the contractor will begin work on the top concrete caps that connect each of the columns. Once those are complete, the bridge girders will be delivered to the site for installation. The girders are expected to begin delivery in 2 weeks.
    • Between 242nd and 247th Ave. SE, traffic has been shifted to the south side of the roadway.Work continues along the north half of the roadway in this area. The contractor and the utility companies will be working on relocations in these limits. Grading work and concrete curb and sidewalk placement will continue through July. The contractor will continue to work in the intersection of 247th Ave. SE near the middle school. Placement of asphalt is expected to occur at the end of July.

    Please note that during peak delays, using the project detour route, Issaquah Beaver Lake Road to Issaquah Pine Lake Road, may result in shorter drive times.

    Project work hours are 7 a.m. to 5 p.m.

    Bridge crews between Klahanie Dr. SE and 247th continue to begin at 7:00 a.m., following the required health check-up. Road crews between 242nd and 247th continue to start at 7:30 a.m., following the required health check-up.

    Update as of 7/3:

    Issaquah-Fall City Road remains closed for construction. Local access will be maintained during the closure. The closure between 247th Place SE and Klahanie Dr. SE is expected to last through December 2020.

    • The temporary roundabout at SE Issaquah-Beaver Lake Rd./256th Ave. SE/SE 32nd St/E Beaver Lake Dr. SE is operational. Only final touch-ups are remaining, which are being scheduled once all the parts arrive. The sidewalk around the intersection will be replaced in July. The work will include relocating existing ramps and placement of new concrete and curb in around the Roundabout to better improve access for pedestrians to the crossing locations.
    • Construction of the bridge has begun. So far all of the underground shafts have been completed. The contractor is currently verifying the installation of the drilled shafts and will start constructing upward out of the ground. The area is closed to the public.
    • Between 242nd and 247th Ave. SE, traffic has been shifted to the south side of the roadway.Work continues along the north half of the roadway in this area. The contractor and the utility companies will be working on relocations in these limits. Also concrete curb and sidewalk placement is expected to begin.
    • The contractor will continue to work in the intersection of 247th Ave. SE near the middle school.

    Please note that during peak delays, using the project detour route, Issaquah Beaver Lake Road to Issaquah Pine Lake Road(External link), may result in shorter drive times. For more information and project updates, please visit the project portal on Connect Sammamish.

    Work hours are 7 a.m. to 5 p.m.

    Bridge crews between Klahanie Dr. SE and 247th have started at 7:00 a.m., following the required health check-up. Road crews between 242nd and 247th have started at 7:30 a.m., following the required health check-up.

  • Three-week look ahead 6/12 - 7/3

    Share on Facebook Share on Twitter Share on Linkedin Email this link
    12 Jun 2020
    supporting image

    Below is your three week look-ahead for 6/12 - 7/3

    Update as of 7/3:

    Issaquah-Fall City Road remains closed for construction. Local access will be maintained during the closure. The closure between 247th Place SE and Klahanie Dr. SE is expected to last through December 2020.

    • The temporary roundabout at SE Issaquah-Beaver Lake Rd./256th Ave. SE/SE 32nd St/E Beaver Lake Dr. SE is operational. Only final touch-ups are remaining, which are being scheduled once all the parts arrive. The sidewalk around the intersection will be replaced in July. The work will include relocating existing ramps and placement of new concrete and curb in around the Roundabout to better improve access for pedestrians to the crossing locations.
    • Construction of the bridge has begun. So far all of the underground shafts have been completed. The contractor is currently verifying the installation of the drilled shafts and will start constructing upward out of the ground. The area is closed to the public.
    • Between 242nd and 247th Ave. SE, traffic has been shifted to the south side of the roadway.Work continues along the north half of the roadway in this area. The contractor and the utility companies will be working on relocations in these limits. Also concrete curb and sidewalk placement is expected to begin.
    • The contractor will continue to work in the intersection of 247th Ave. SE near the middle school.

    Please note that during peak delays, using the project detour route, Issaquah Beaver Lake Road to Issaquah Pine Lake Road, may result in shorter drive times. For more information and project updates, please visit the project portal on Connect Sammamish.

    Work hours are 7 a.m. to 5 p.m.

    Bridge crews between Klahanie Dr. SE and 247th have started at 7:00 a.m., following the required health check-up. Road crews between 242nd and 247th have started at 7:30 a.m., following the required health check-up.

    Update as of 6/19:

    Issaquah-Fall City Road remains closed for construction. Local access will be maintained during the closure. The closure between 247th Place SE and Klahanie Dr. SE is expected to last through December 2020.

    • The temporary roundabout at SE Issaquah-Beaver Lake Rd./256th Ave. SE/SE 32nd St/E Beaver Lake Dr. SE is operational. Only final touch-ups are remaining, which are being scheduled once all the parts arrive. The sidewalk around the intersection will be replaced in July. The work will include relocating existing ramps and placement of new concrete and curb in around the Roundabout to better improve access for pedestrians to the crossing locations.
    • Construction of the bridge has begun. So far all of the underground shafts have been completed. The contractor is currently verifying the installation of the drilled shafts and will start constructing upward out of the ground. The area is closed to the public.
    • Between 242nd and 247th Ave. SE, traffic has been shifted to the south side of the roadway.Work continues along the north half of the roadway in this area. The contractor and the utility companies will be working on relocations in these limits. Also concrete curb and sidewalk placement is expected to begin.
    • The contractor will continue to work in the intersection of 247th Ave. SE near the middle school.

    Please note that during peak delays, using the project detour route, Issaquah Beaver Lake Road to Issaquah Pine Lake Road, may result in shorter drive times. For more information and project updates, please visit the project portal on Connect Sammamish.

    Work hours are 7 a.m. to 5 p.m.

    Bridge crews between Klahanie Dr. SE and 247th have started at 7:00 a.m., following the required health check-up. Road crews between 242nd and 247th have started at 7:30 a.m., following the required health check-up.

    Update as of 6/12:

    Issaquah-Fall City Road remains closed for construction. Local access will be maintained during the closure. The closure between 247th Place SE and Klahanie Dr. SE is expected to last through December 2020.

    • The temporary roundabout at SE Issaquah-Beaver Lake Rd./256th Ave. SE/SE 32nd St/E Beaver Lake Dr. SE is operational. Only final touch-ups are remaining, which are being scheduled once all the parts arrive.
    • Construction of the bridge has begun. So far all of the underground shafts have been completed. The contractor is currently verifying the installation of the drilled shafts and will start constructing upward out of the ground. The area is closed to the public.
    • Between 242nd and 247th Ave. SE, traffic has been shifted to the south side of the roadway.Work continues along the north half of the roadway in this area.
    • The contractor will continue to work in the intersection of 247th Ave. SE near the middle school.

    Please note that during peak delays, using the project detour route, Issaquah Beaver Lake Road to Issaquah Pine Lake Road, may result in shorter drive times. For more information and project updates, please visit the project portal on Connect Sammamish.

    Work hours are 7 a.m. to 5 p.m.

    Bridge crews between Klahanie Dr. SE and 247th have started at 7:00 a.m., following the required health check-up. Road crews between 242nd and 247th have started at 7:30 a.m., following the required health check-up.


  • Three Week Look-Ahead 5/29 - 6/12

    Share on Facebook Share on Twitter Share on Linkedin Email this link
    03 Jun 2020
    supporting image

    Below is your three week look-ahead for 5/29 - 6/12

    Update as of 6/5/20

    Issaquah-Fall City Road remains closed for construction. Local access will be maintained during the closure. The closure between 247th Place SE and Klahanie Dr. SE is expected to last through December 2020.

    • The temporary roundabout at SE Issaquah-Beaver Lake Rd./256th Ave. SE/SE 32nd St/E Beaver Lake Dr. SE is operational. Only final touch-ups are remaining, which are being scheduled once all the parts arrive.
    • Construction of the bridge has begun. So far all of the underground shafts have been completed. The contractor is currently verifying the installation of the drilled shafts and will start constructing upward out of the ground. The area is closed to the public.
    • Between 242nd and 247th Ave. SE, traffic has been shifted to the south side of the roadway.Work continues along the north half of the roadway in this area.
    • The contractor will continue to work in the intersection of 247th Ave. SE near the middle school.

    Please note that during peak delays, using the project detour route, Issaquah Beaver Lake Road to Issaquah Pine Lake Road, may result in shorter drive times. For more information and project updates, please visit the project portal on Connect Sammamish.

    Work hours are 7 a.m. to 5 p.m.

    Bridge crews between Klahanie Dr. SE and 247th have started at 7:00 a.m., following the required health check-up. Road crews between 242nd and 247th have started at 7:30 a.m., following the required health check-up.

    Update as of 5/29/20

    Issaquah-Fall City Road remains closed for construction. Local access will be maintained during the closure. The closure between 247th Place SE and Klahanie Dr. SE is expected to last through December 2020.

    • The temporary roundabout at SE Issaquah-Beaver Lake Rd./256th Ave. SE/SE 32nd St/E Beaver Lake Dr. SE is operational. Only final touch-ups are remaining, which are being scheduled once all the parts arrive.
    • Construction of the bridge has begun. So far, 6 of the 12 drilled underground shafts have been completed. Six more remain, then they will start building the above-ground work. The area is closed to the public.

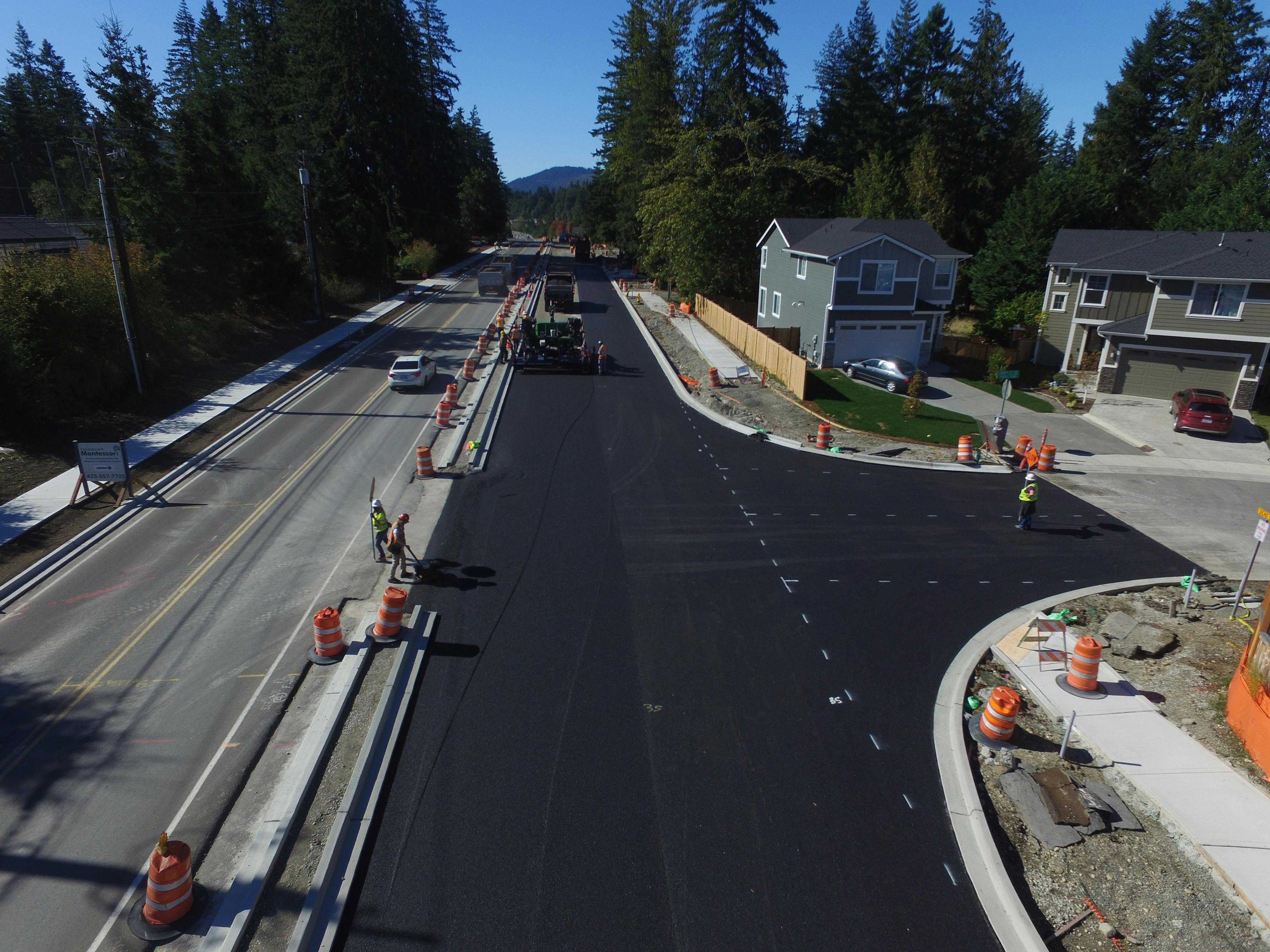

    • Paving between 242nd and 247th Ave. SE is complete. Traffic has been shifted to the south side of the roadway.Work has started along the north half of the roadway in this area.
    • The contractor will continue to work in the intersection of 247th Ave. SE near the middle school.
    • Starting next week, the bridge work will be coming out of the ground and starting to move up.

    Please note that during peak delays, using the project detour route, Issaquah Beaver Lake Road to Issaquah Pine Lake Road, may result in shorter drive times.

    Updated: Work hours are 7 a.m. to 5 p.m.

    Bridge-drilling crews between Klahanie Dr. SE and 247th have started at 7:00 a.m., following the required health check-up. Road crews between 242nd and 247th have started at 7:30 a.m., following the required health check-up.
