Ebright Creek Fish Passage

Share on Facebook Share on Twitter Share on Linkedin Email this link

This project page features the most recent activities on the project. For background on the project click here.

The goal of the project is to restore the Ebright Creek crossing at East Lake Sammamish Parkway. To do this, the project will remove the existing culvert pipes and replace them with a fully fish passable box culvert, with the goals of improving stream habitat and fish passage to support Kokanee salmon and other fish species. During construction, drivers can expect intermittent lane closures. Starting Monday, August 16th there will be a minimum 3-week closure of East Lake Sammamish Parkway at Ebright Creek to allow for installation of the box culvert.

Please check back for regular updates!

Project Team:

  • Stephanie Sullivan, Project Manager, City of Sammamish
  • Nagwan Al-Janabi, Construction Manager, KBA, Inc.
  • Mike Dysert, Contractor, Johansen Construction Company, LLC
  • Laura Ruppert, Design Consultant, Osborn Consulting, Inc.

This project page features the most recent activities on the project. For background on the project click here.

The goal of the project is to restore the Ebright Creek crossing at East Lake Sammamish Parkway. To do this, the project will remove the existing culvert pipes and replace them with a fully fish passable box culvert, with the goals of improving stream habitat and fish passage to support Kokanee salmon and other fish species. During construction, drivers can expect intermittent lane closures. Starting Monday, August 16th there will be a minimum 3-week closure of East Lake Sammamish Parkway at Ebright Creek to allow for installation of the box culvert.

Please check back for regular updates!

Project Team:

  • Stephanie Sullivan, Project Manager, City of Sammamish
  • Nagwan Al-Janabi, Construction Manager, KBA, Inc.
  • Mike Dysert, Contractor, Johansen Construction Company, LLC
  • Laura Ruppert, Design Consultant, Osborn Consulting, Inc.
  • ELSP Reopening Scheduled 9/16 and 3-week Look Ahead 8/31 - 9/20

    Share on Facebook Share on Twitter Share on Linkedin Email this link

    East Lake Sammamish Parkway is scheduled to reopen by end of day 9/16. This is subject to change should unforeseen issues arise.


    The project is continuing with many tasks to finish over the next month.

    1. Finish new water main connection.
    2. Finish new sewer connection.
    3. Complete culvert installation, fill with material, and backfill.
    4. Stream realignment, grading, and install large woody debris.
    5. Turn off stream bypass.
    6. Install landscaping and irrigation.
    7. Restore laydown yard.
    8. Pave and stripe roadway.
    9. ELSP reopen by end of day 9/16.


  • Salmon SEEson is coming!

    Share on Facebook Share on Twitter Share on Linkedin Email this link
    supporting image

    From the Cedar/Lake Washington Salmon Recovery News for August 2021:

    Fall is coming and salmon will be returning to streams and rivers throughout King County to spawn. The annual Salmon SEEson program will run from late August through November, promoting self-guided salmon viewing sites as well as some hosted events (stay tuned!). If you decide to visit a self-guided site near you, please remember to: plan ahead, practice social distancing, wear a mask, leave no trace, and contribute to an inclusive experience for all. Check out the Salmon SEEson website for more information on self-guided and viewing opportunities!


  • Project Updates 8/26

    Share on Facebook Share on Twitter Share on Linkedin Email this link

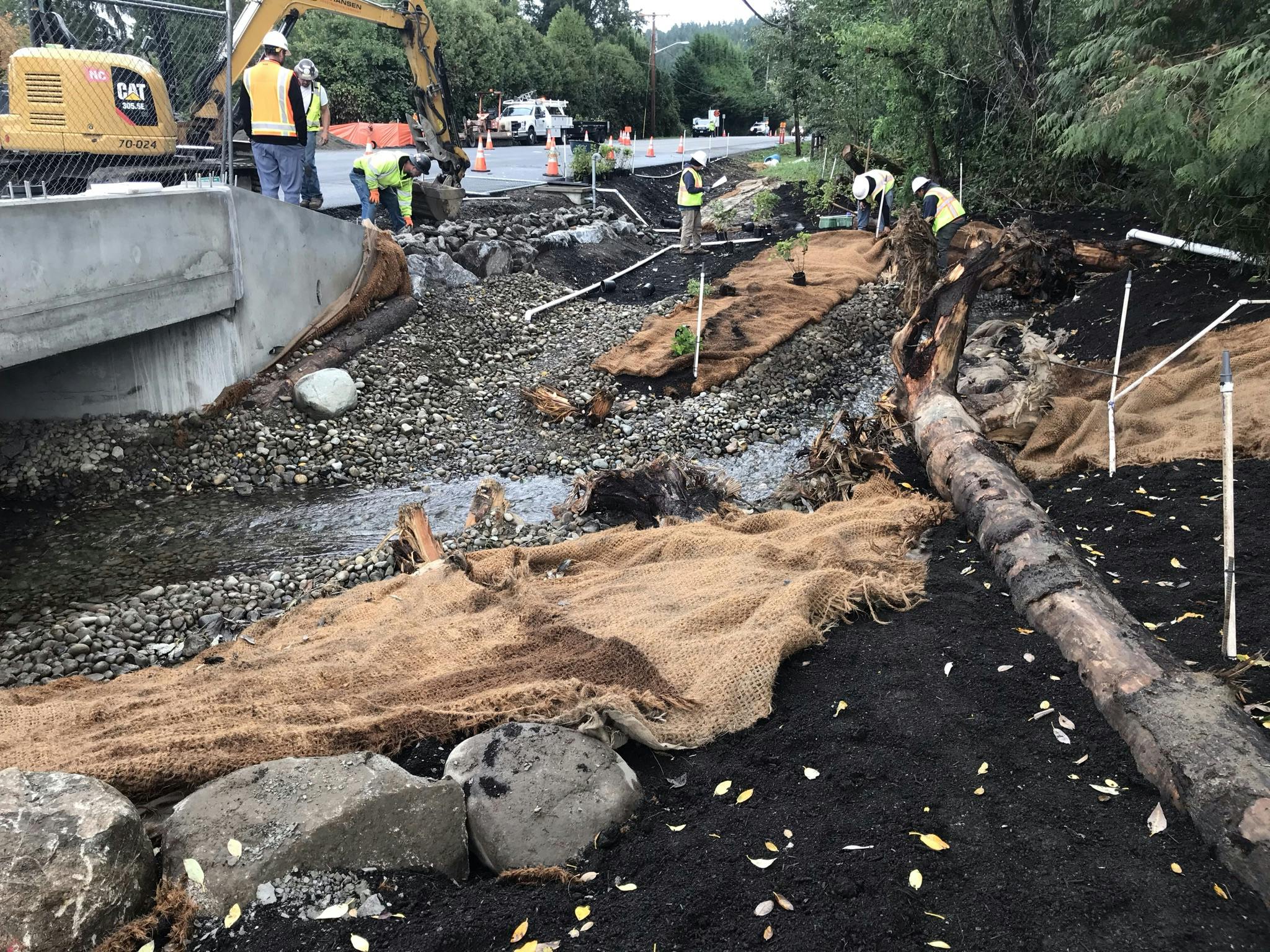

    supporting image
    1. Tree removals are complete.
    2. Excavation for the new culvert area is complete.
    3. Sewer bypass system is installed and operating.
    4. Culvert bottom sections and wing walls delivered and installed.
    5. Installation of the new sewer system is underway.


    Upcoming Work

    1. Fill culvert with streambed material.
    2. Install culvert lids.
    3. Backfill culvert.
    4. Begin grading to prepare for road repaving.
    5. Begin upland/stream restoration, as time allows.
  • Project Updates and Three-week Look Ahead 8/16 - 9/3

    Share on Facebook Share on Twitter Share on Linkedin Email this link

    Project Updates

    1. Dewatering system is installed and operating.
    2. Fish were relocated and the stream bypass system is installed and operating. See photos section for some fish photos!
    3. Installed the new water main under the culvert and will connect to main line.
    4. East Lake Sammamish Parkway is closed 24 hours a day from 8/16 through September. A detour is posted and signs are being adjusted, as needed, to mitigate traffic impacts. See documents section for detour map!
    5. Due to limited access during the East Lake Sammamish Parkway closure, Republic Services will begin garbage, yard waste, and recycling collection at 6:00 a.m. on Tuesdays, the regular collection day for homes adjacent to the closure. Impacted homes will be receiving calls from Republic on 8/23 and 8/30 as a reminder before pick-up. We ask homes that receive a call to please have your carts out by 6:00 a.m. on August 24th and 31st.
    6. Road was demolished and removed.


    The 3-Week Look Ahead gives us a realistic idea of the activities planned. Changes and unexpected conditions or events can occur that will cause this schedule to change over time.

    1. Tree removals are on-going.
    2. Clearing and grubbing the upland area, preparing for stream realignment to the new culvert crossing.
    3. Excavate the new culvert area.
    4. Install the sewer bypass system.
    5. Culvert delivery and installation of culvert bottom sections.
    6. Install new sewer system.
    7. Fill culvert with streambed material.
    8. Install culvert lids.
    9. Backfill culvert.
    10. Begin grading to prepare for road repaving.
    11. Begin upland/stream restoration, as time allows.
  • NOTICE: Extended Work Hours 8/16 - 9/3

    Share on Facebook Share on Twitter Share on Linkedin Email this link

    The City has granted the contractor permission for extended working hours starting Monday, August 16th through Friday, September 3rd, 7:00 AM - 10:00 PM. This is to ensure the road closure and construction will be completed within the planned schedule.

    REMINDER!!!!!

    East Lake Sammamish Parkway will close to thru traffic for a minimum of 3-weeks starting Monday, August 16th. Please follow the detour and consider alternate routes. Bicyclists and pedestrians can use the trail to detour around the closure.

  • Three-week Look Ahead 8/9 - 8/27

    Share on Facebook Share on Twitter Share on Linkedin Email this link
    supporting image

    The 3-Week Look Ahead gives us a realistic idea of the activities planned. Changes and unexpected conditions or events can occur that will cause this schedule to change over time.

    1. Tree removals are on-going.
    2. Clearing and grubbing the upland area, preparing for stream realignment to the new culvert crossing.
    3. Install dewatering well points to dewater (dry out) the excavation area. Turn on dewatering system (pumps will be running through-out this work).
    4. Fish block nets and fish relocation.
    5. Install and start the stream bypass system.
    6. Install the new water main under the culvert.
    7. Set up detour and close East Lake Sammamish Parkway, starting 8/16.
    8. Demolish the area of the existing road and remove.
    9. Excavate the new culvert area.
    10. Culvert delivery and installation of culvert bottom sections.
    11. Begin upland/stream restoration, as time allows.

    Image: This shows an excavator with an attachment called a hydraulic breaker. It is being used to break up the pavement that will be removed. This is one of two areas that will have a dewatering header pipe, which collects the water that is pulled from the ground. This will dry out the excavation area which is below the water table, to allow installation of the new culvert.

  • East Lake Sammamish Parkway Road Closure Starting 8/16

    Share on Facebook Share on Twitter Share on Linkedin Email this link
    supporting image

    Starting August 16th there will be a minimum 3-week closure of East Lake Sammamish Parkway at Ebright Creek (located approximately at 125 E Lake Sammamish Parkway). The closure will allow for completion of the new water and sewer systems and installation of the box culvert. Additional notifications and message boards will be posted and a signed detour will be in place. View detour plan here.

    Drivers should expect delays and consider using alternate routes.

    Image: The closure area is relatively small, but through-access will not be permitted. This simplified detour map shows the primary detour route for vehicular traffic. There will be local access only on either side of the closure area. Drivers should consider alternate routes that may work better for their destination. During the closure, bicyclists and pedestrians will be able to detour around the closure using the East Lake Sammamish Regional Trail.

  • Three Week Look-Ahead 7/19 - 8/6

    Share on Facebook Share on Twitter Share on Linkedin Email this link

    The 3-Week Look Ahead gives us a realistic idea of the activities planned. Changes and unexpected conditions or events can occur that will cause this schedule to change over time.

    1. Eliminate the utility conflicts with Comast and Ziply.
    2. Traffic control and the construction access will be set up.
    3. Tree removals and tree protection for those to remain will be installed.
    4. Clearing and grubbing the upland area.
    5. Prepare for and install the water bypass pipe and the new water main under the culvert.
    6. Install fish screens and prepare to install the stream bypass system.
    7. Install dewatering well points to prepare for dewatering the excavation area.
  • Project Update - June 2021

    Share on Facebook Share on Twitter Share on Linkedin Email this link
    • On-going review of submittals and RFIs.
    • Draft baseline schedule shows Notice to Proceed anticipated on 7/1.

    Utility Relocations:

    • Comcast obtaining a King County Special Use Permit for temporary pole.
    • PSE cut and capped the gas line. PSE to return to reinstall gas line after culvert is installed.
    • PSE scheduled transmission lines relocation for first week in July.
    • Ziply working to schedule pole relocation.


  • Project Update - May 2021

    Share on Facebook Share on Twitter Share on Linkedin Email this link
    • Held an on-site strategy meeting with utilities on May 6th, 2021.
    • Held the preconstruction conference on May 11th, 2021.
    • Reviewed and issued ROW permits and coordinated utility relocation.
    • Approved the King County Special Use Permit.
    • Approved the project Interlocal Agreement between the City and Sammamish Plateau Water and Sewer District.
    • Received contractor's draft project schedule.
