Three Week Look-Ahead 1/29 - 2/19
Below is your three week look-ahead for 1/29 - 2/19:
Update as of 2/18/21:
Issaquah-Fall City Road remains closed for construction. Local access will be maintained during the closure. The closure between 247th Place SE and Klahanie Dr. SE will remain until May 1, 2021.
*Safety Reminder – Please observe the contractor’s “Sidewalk Closed” and “No Trespassing” signs at all times.
- Bridge barrier pour scheduled this week on south side of bridge.
- Moment slab rebar is being installed now at bridge approach, and the last segment will soon be poured.
- PSE Gas continues to install utilities under the bridge.
- Curb installation at splitter island and median islands underway.
- Roundabout truck aprons at 242nd and SE Klahanie Drive are being constructed.
- Roundabout landscape preparation is underway.
Update as of 2/11/21:
Issaquah-Fall City Road remains closed for construction. Local access will be maintained during the closure. The closure between 247th Place SE and Klahanie Dr. SE will remain until May 1, 2021.
- PSE Gas main installation under bridge continues for approximately 2 more weeks.
- Storm sewer and water main installation under bridge continues.
- Sidewalk construction on north side of bridge is completed.
- Barrier on the south side of bridge is being formed.
- Concrete work continues over next 2 weeks for medians, stamped concrete, and remaining sidewalks, followed by road grade preparation for paving.
- Trenching continues to bring power to streetlights.

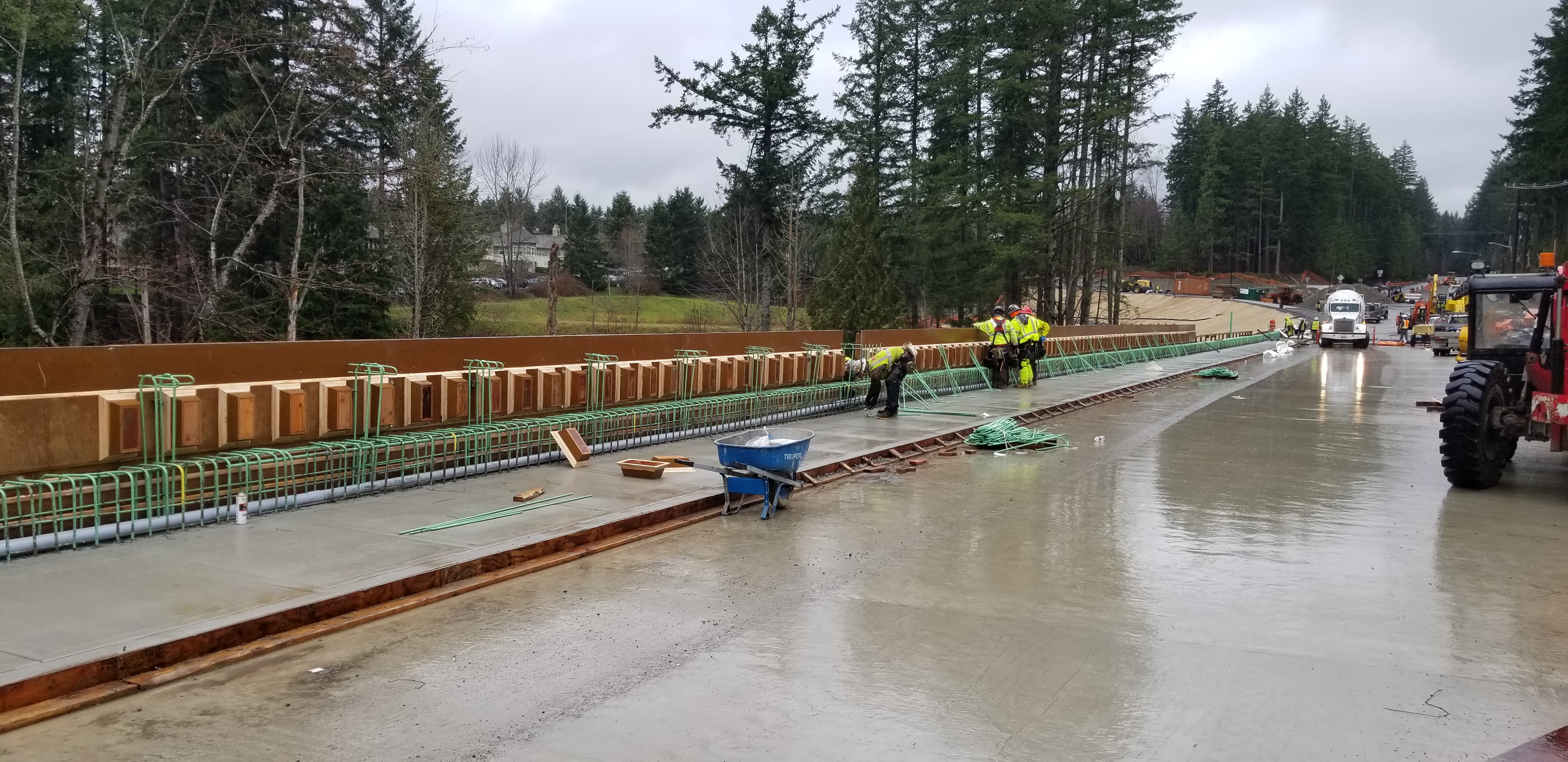

- Construction Photos:
|
|
|
|
Updates as of 2/5/2021:
Issaquah-Fall City Road remains closed for construction. Local access will be maintained during the closure. The closure between 247th Place SE and Klahanie Dr. SE will remain until May 1, 2021.
- Utility installation under bridge – dry utilities have been completed, with water main and storm sewer installation now underway.
- Bridge barrier concrete pour scheduled for next week.
- PSE Gas utility relocation (by third party) continues within the bridge approaches.
- New pedestrian crossing signal (HAWKS) at the Pacific Cascade Middle School entrance is now activated, and streetlights are being wired for power.
- Base paving done at intersections of 242nd, 247th and Klahanie Drive SE, opening roundabouts for circulation.
- The large new detention pond at Klahanie Drive SE has been completed and is now collecting stormwater.
- Curbs and gutters for roundabouts and median islands will be installed over next 2 weeks.
Update as of 1/29:
Due to unforeseen circumstances, including construction delays caused by necessary third party utility relocations and inclement weather, the City of Sammamish Public Works Department has determined the road opening by end of January is not feasible.
The City of Sammamish has looked at options to hasten the construction or partial openings, but has determined in an abundance of caution that these options are not safe nor realistic due to weather events and fiscal constraints.
Upon reviewing the contractor's updated and current schedule, and the status of utility relocations, the bridge and roadway are now scheduled to be opened to traffic on May 1, 2021.
We understand and apologize for this inconvenience and thank you for your continued patience as we work to improve the City’s traffic flow.
Daytime Project work hours are 7:30 a.m. to 5 p.m., Saturday Work Hours 9:00 a.m. – 6 p.m.
Consultation has concluded
